Commercial Concrete Flooring Anderson IN

A warehouse or retail floor that doesn't meet flatness tolerances is a forklift safety issue and a racking alignment problem on day one. We pour commercial slabs-on-ground to ACI 360R specifications: 5000 PSI mix, 10-mil vapor barrier, rebar or welded wire per the structural engineer's load spec, control joints at column lines, and flatness measured against FF/FL tolerances before we leave the site. New construction, tenant buildout, and full-depth slab replacement within occupied buildings. Fixed-price quote within 48 hours.

Anderson Pendleton Noblesville Fishers Carmel Westfield Zionsville
Commercial Floor Specifications
Mix Strength
5000 PSI · industrial loads / 4000 PSI light commercial
Thickness
5"–6" standard · 8"+ heavy industrial per engineer
Vapor Barrier
10-mil polyethylene under slab
Reinforcement
#4 or #5 rebar · or WWF per structural spec
Flatness
FF ≥ 35 / FL ≥ 25 standard · FF 50+ for racking
Control Joints
At column lines · max panel 25× slab depth
Base
6" #53 stone compacted to Standard Proctor density
Warranty
60-day workmanship
01 · Engineering

What separates a commercial floor from a residential slab.

The primary difference is load classification — and load classification determines everything downstream: thickness, reinforcement, joint spacing, and mix design. A residential garage floor carries passenger vehicles and foot traffic. A commercial warehouse floor carries forklifts loaded to 10,000 lbs, racking systems anchored into the slab, and concentrated point loads from rack feet. The slab design process starts with the structural engineer's load analysis, not a rule-of-thumb thickness.

The second major difference is flatness. Forklift stability in a high-racking environment depends on floor flatness — a floor that rides out of flat even modestly causes mast oscillation at height, which is both a damage risk and a safety hazard. ACI 360R defines floor flatness in two numbers: FF (floor flatness — smoothness of the surface over short intervals) and FL (floor levelness — how flat the floor is over longer spans). For racking applications, an FF of 50 or higher is commonly specified by the racking manufacturer.

Vapor barrier — why commercial floors need it even more than residential

Moisture vapor transmission through a slab-on-ground is a code issue in commercial construction when the floor finish system includes adhesive-bonded flooring, coatings, or epoxy. Without a proper vapor barrier, moisture migrates up through the slab and debonds the finish system. We install a 10-mil polyethylene vapor barrier as standard on all commercial pours — lapped at seams, taped, and turned up at the slab perimeter.

02 · Spec Sheet

Every commercial floor we pour.

Concrete Mix
5000 PSI industrial · 4000 PSI light commercial · air-entrained if freeze-thaw exposed
Slab Thickness
5" light commercial · 6" warehouse/forklift · 8"+ heavy industrial per structural engineer
Vapor Barrier
10-mil polyethylene · lapped 12" at seams · taped · turned up at perimeter
Base Course
6" #53 INDOT stone compacted to Standard Proctor density
Reinforcement
#4 or #5 rebar at 12"–18" O.C. · or welded wire fabric (WWF) per structural spec
Control Joints
At every column line · max panel dimension = 25× slab depth per ACI 360R
Flatness
FF ≥ 35 / FL ≥ 25 standard construction · FF 50+ racking / narrow-aisle applications
Surface Finish
Power trowel to dense, hard finish standard · burnished/polished prep available
Curing
Curing compound day 1 · no foot or vehicle traffic per schedule
03 · Process

Seven steps, start to finish.

Commercial pour schedules depend on building access, structural steel or wall timing, and GC coordination. We work with the general contractor's schedule on new construction. Tenant buildout and replacement pours are scoped independently. Most commercial slab pours are complete in 1–3 days of pour time depending on square footage — base prep and scheduling add lead time.

01

Estimate & Plan

Walk the facility, review structural engineer's slab design, confirm load classification, thickness spec, and FF/FL requirement. Coordinate with GC schedule for new construction. Fixed-price quote within 48 hours for standalone work.

02

Demo (If Required)

Sawcut and remove existing slab in sections for full replacement. Haul concrete off-site same day. Coordinate access for occupied-building work to minimize operational disruption.

03

Subgrade & Base

Proof-roll native subgrade to identify soft spots — undercut and replace failing areas with compacted granular fill. Place 6" of #53 stone, compact to Standard Proctor density. Verify base elevation throughout.

04

Vapor Barrier & Rebar

10-mil poly vapor barrier placed, lapped, and taped. Rebar or WWF installed per structural spec. Column line joint locations marked. Edge forms set.

05

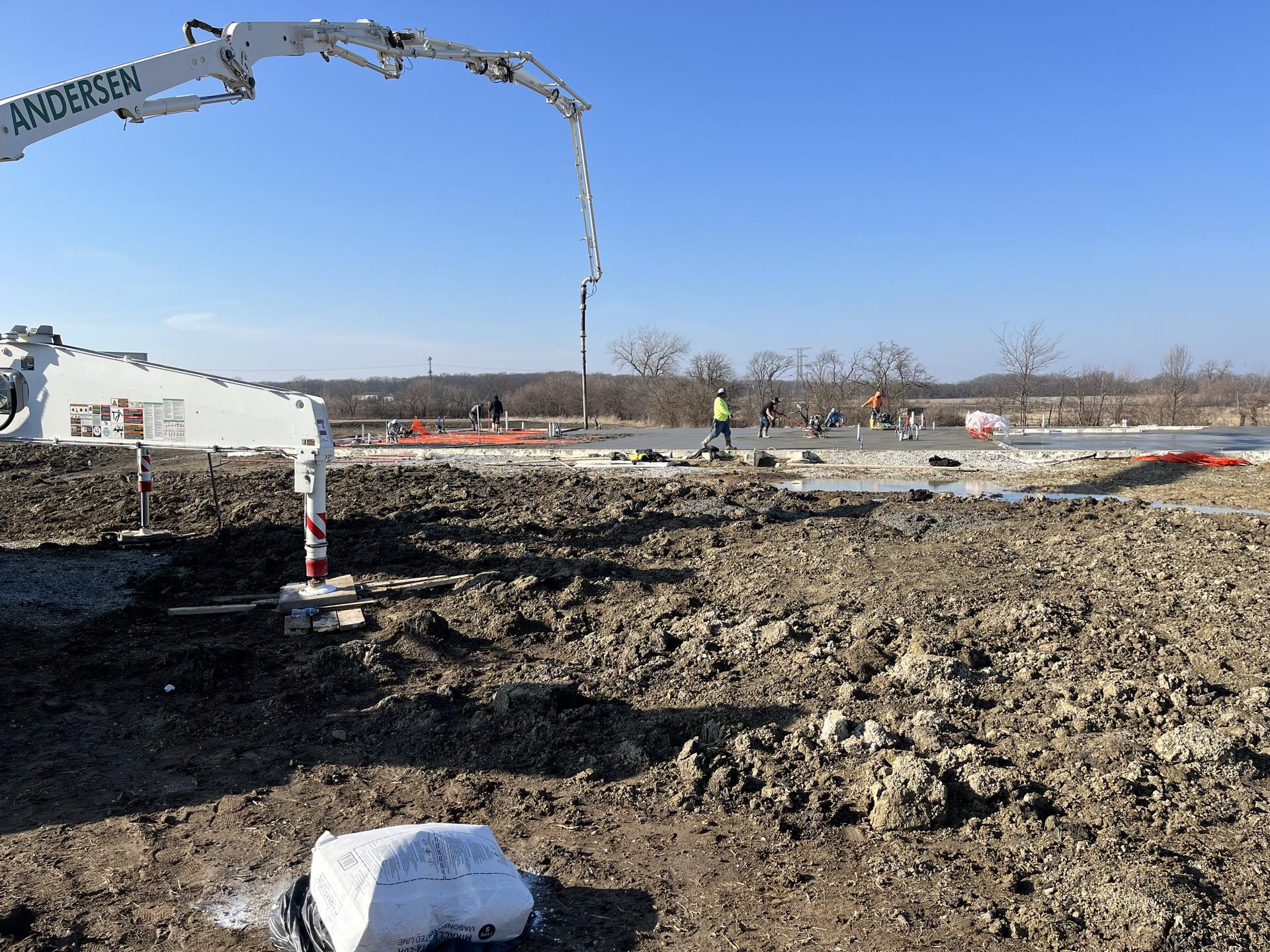

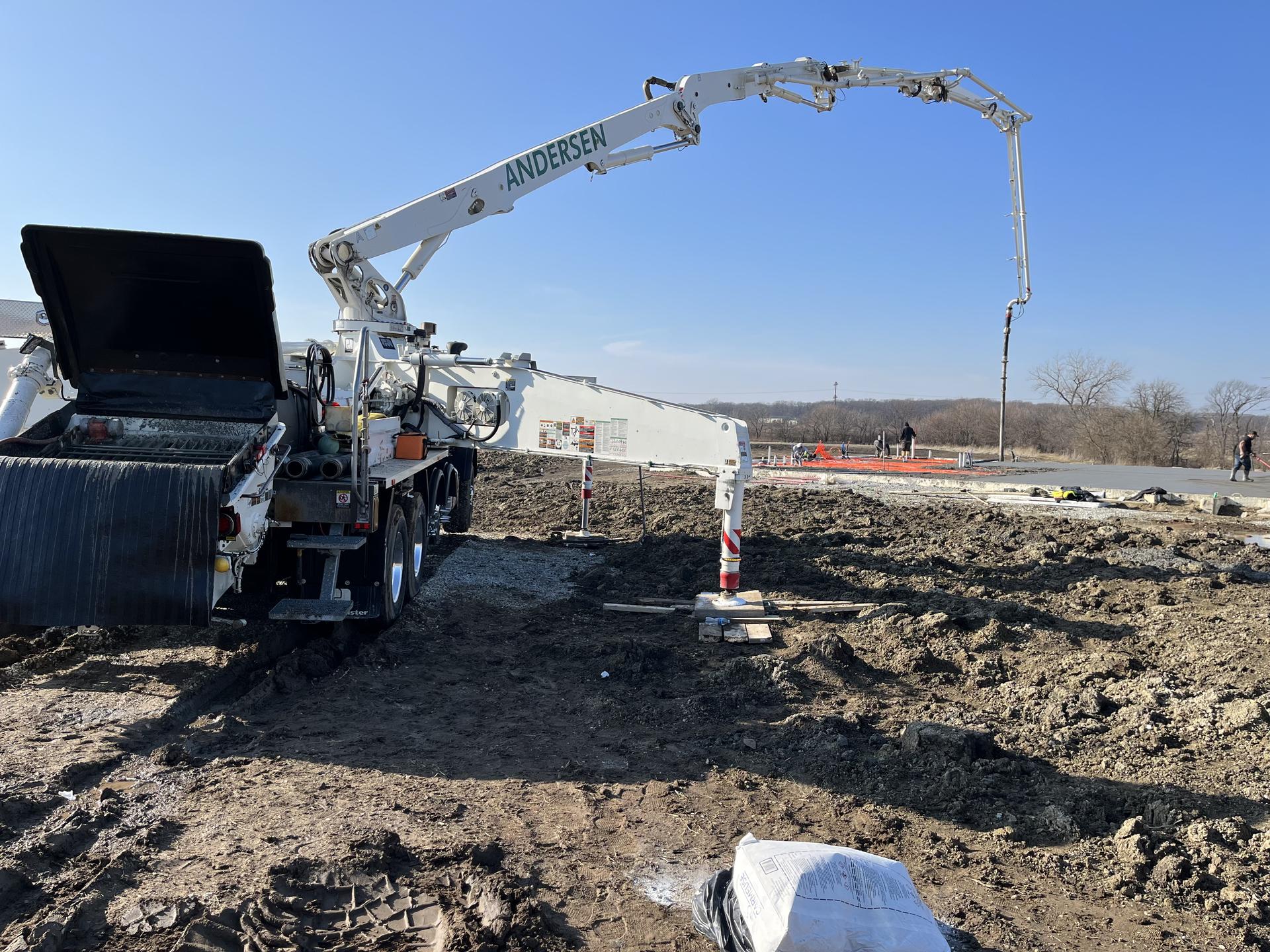

Pour & Strike

Ready-mix truck sequencing planned for continuous pour without cold joints. Concrete placed, consolidated, and struck off. Laser screed or hand screed depending on FF/FL specification.

06

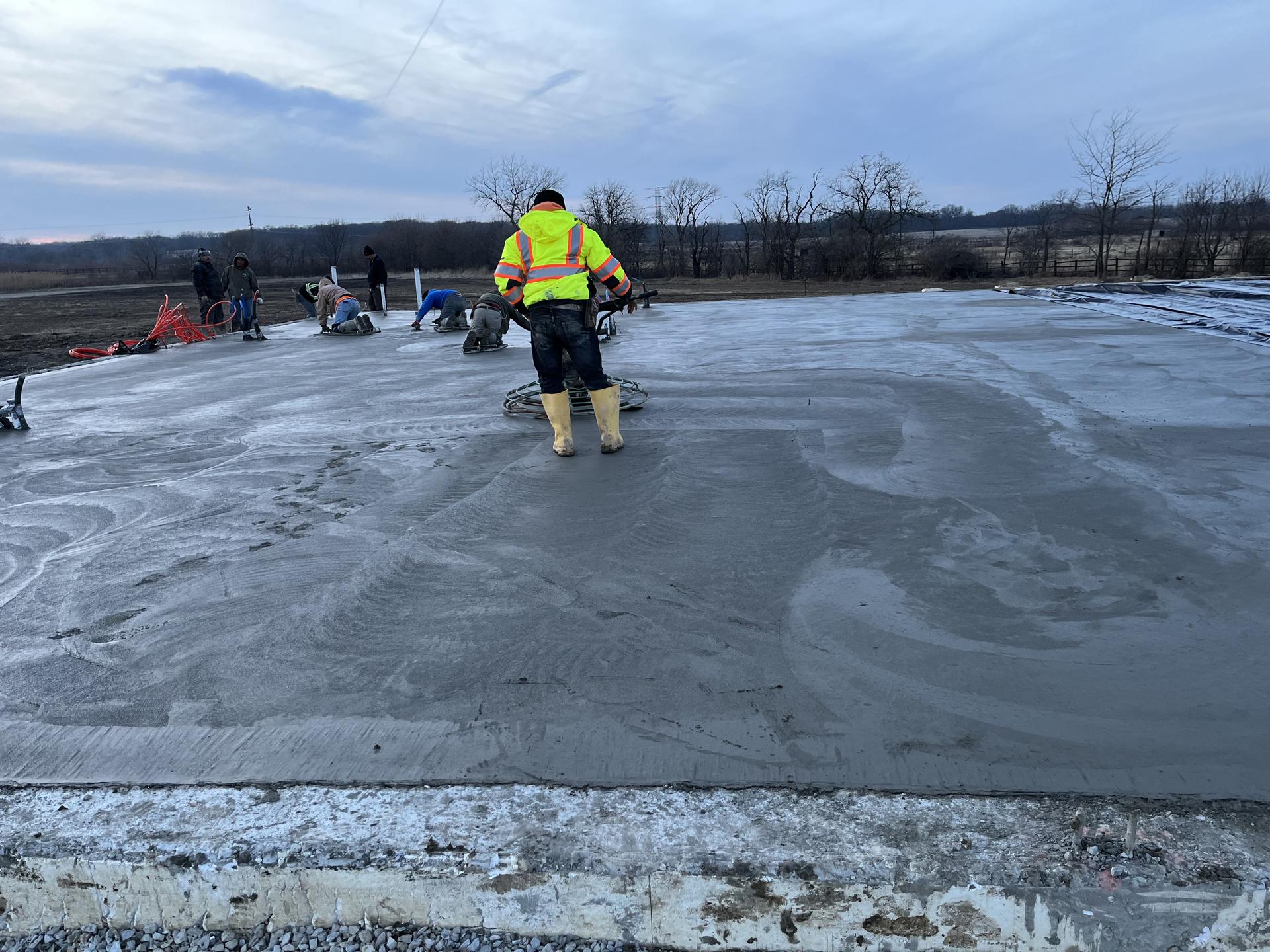

Power Trowel & Finish

Ride-on or walk-behind power trowel to achieve dense, hard surface finish. Multiple passes to reach FF target. Saw-cut control joints at column lines within 12 hours of pour.

07

Cure, Inspect & Closeout

Curing compound applied, surface protected per schedule. FF/FL readings taken before acceptance. 60-day workmanship warranty issued. Permits closed out.

04 · Local Notes

Commercial concrete conditions in our service area.

Anderson: The I-69 corridor and SR-9 commercial zones in Anderson have seen steady industrial development. Madison County's clay subgrade requires subgrade verification and proof-rolling before commercial base prep — soft pockets under a commercial slab become differential settlement problems within a few years of forklift traffic.

Pendleton: I-69 interchange commercial development at Pendleton includes distribution and light industrial facilities. We've done warehouse floor pours in Pendleton where subgrade conditions required undercut and replacement — that soil verification step isn't optional in this county.

Noblesville & Fishers: SR-37 / I-69 corridor in Hamilton County has some of the highest commercial development density in our service area. Tenant buildout flatwork for retail and office in Fishers frequently requires matching an existing slab elevation with a new pour — laser screed work to hit a tight FF while matching adjacent slab height.

Carmel & Westfield: Commercial construction quality standards are higher in these markets — GCs and inspectors are thorough. We welcome the scrutiny. Our mix tickets, compaction reports, and FF/FL measurements are available on request for every commercial pour.

05 · FAQ

What people ask before they call.

What FF/FL number do I need for a forklift warehouse?
Standard warehouse construction typically targets FF ≥ 35 / FL ≥ 25. Narrow-aisle and very-narrow-aisle (VNA) forklift applications require FF 50 or higher — the forklift manufacturer typically specifies the minimum floor flatness in their equipment documentation. We pour to whatever the racking or equipment spec requires. If you don't have a spec, we'll default to FF 40 / FL 30 for general warehouse use.
Do I need a structural engineer's drawing for a commercial floor?
For new construction, yes — the building permit requires structural drawings that include the slab design. For tenant buildout replacement pours, it depends on the local jurisdiction and the load classification. We'll advise on what's required when we review the project. If the GC already has structural drawings, we work from those.
Can you replace a commercial floor while the building is occupied?
Yes — we've done phased replacements in occupied warehouses. The process is: section off the pour zone, saw-cut and remove the existing slab in that zone, base prep, pour and cure, then move to the next zone. It takes longer than a single full pour and requires coordination with the operations team on access and timeline. We scope occupied-building work carefully on the estimate visit.
What's the difference between a hard trowel and a burnished finish?
A hard trowel finish is a dense, smooth surface achieved through multiple power trowel passes — it's the standard commercial floor finish, suitable for most warehouse and industrial uses. A burnished finish adds additional mechanical polishing passes to achieve a higher-gloss surface. For floors that will receive epoxy coatings or polished concrete, we provide hard trowel plus a surface profile that accepts the coating system.
How thick does a concrete floor need to be for a 10,000 lb forklift?
A 6-inch 5000 PSI slab with proper rebar reinforcement handles standard warehouse forklift loads in most conditions. The actual design depends on the forklift's wheel configuration and loaded weight, the rack leg point loads, and the subgrade bearing capacity. These inputs feed into an ACI 360R slab design check — not a rule-of-thumb. We verify thickness with the structural engineer's spec before pouring.
06 · External

Spec validated by industry standards.

Our commercial slab design, thickness, reinforcement, control joint spacing, and FF/FL flatness tolerances follow ACI 360R "Design of Slabs-on-Ground" — the primary industry standard for industrial and commercial floor construction. ACI 360R defines floor flatness measurement methodology, load classifications, and construction tolerance requirements that govern every commercial slab we pour.

REF · ACI ACI 360R — Design of Slabs-on-Ground
