SERVICE ENTITY · DIG & LEVEL

Excavation & Grading Anderson IN

Need footers cut for a new build? Subgrade prepped for a slab pour? Lot graded so water actually drains? We dig, strip, cut-and-fill, and laser-level — from a 24" footer trench to a full commercial pad. Then we compact #53 stone in 6" lifts to Standard Proctor density so the concrete that lands on top stays flat for 30 years.

Anderson Pendleton Noblesville Fishers Carmel Westfield Zionsville
Service Specifications
Excavation
Footers, foundations, slab pads
Compaction
Standard Proctor density
Method
ASTM D698
Lift Depth
6" max per pass
Stone
#53 INDOT spec
Grade Tolerance
±¼" laser-checked
Slope-Away
Min. 1% from structures
01 · Scope

What "excavation & grading" actually covers.

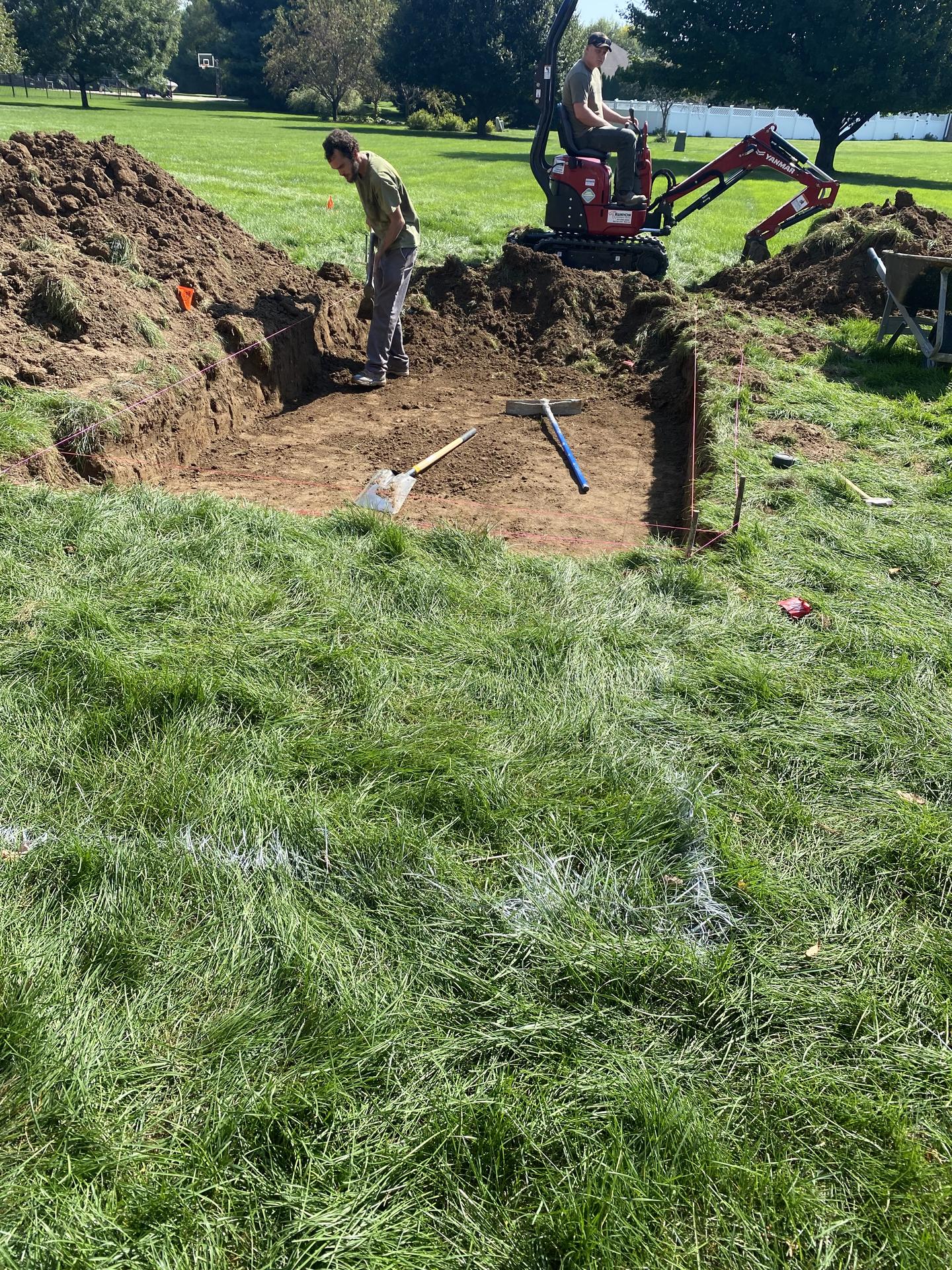

Excavation is the dig. Grading is the level. Most concrete jobs need both, in that order, and most slab failures trace back to one or the other being done wrong before the truck ever showed up.

Excavation we handle

  • Footer trenches for new construction — depth to frost line (32" minimum in Madison County), width per footing schedule.
  • Foundation digs — full-perimeter excavation for crawl spaces, walkout basements, and slab-on-grade builds.
  • Slab pads — pole barns, garages, patios, parking lots — cut to depth for stone base + slab thickness.
  • Utility trenches tied into a concrete scope — water service, electrical conduit, drain tile under slabs.
  • Spoil management — stockpile on-site for reuse, or haul off at quoted rate.

Grading we deliver

  • Rough grade — bulk cut-and-fill to balance the site and shed water.
  • Fine grade — laser-level subgrade to ±¼" for slab pours.
  • Slope-away — minimum 1% (⅛" per foot) away from any structure, every time.
  • Final yard grade — topsoil respread and raked smooth after concrete sets.
02 · Engineering

Why subgrade decides slab life.

You can pour the best 4000 PSI mix on earth and it will still crack within two winters if the subgrade isn't right. Concrete fails in tension, and tension comes from differential settlement underneath. One soft spot the size of a dinner plate becomes a crack that runs the length of the slab.

Madison County's clay-heavy soils swell when wet and shrink when dry — a 4-inch seasonal heave is normal. The fix isn't more concrete. It's a properly prepared base that distributes load evenly and drains water away before it reaches the clay.

What "Standard Proctor density" actually means

Standard Proctor (ASTM D698) is the lab-determined maximum density of a soil at optimum moisture. We compact to 95% of that value — the threshold above which slab settlement under load becomes negligible. We test density with a nuclear gauge or sand-cone method on commercial work; on residential we document lift count and roller passes against the same spec.

03 · Spec Sheet

Every dig and every grade, every time.

Utility Locates
811 IUPPS verified before any digging · 2-business-day notice
Footer Depth
32" minimum to frost line · deeper per engineering
Topsoil Strip
All organics removed to firm native soil · stockpiled or hauled per scope
Soft Spots
Over-excavated and bridged with #53 stone or engineered fill
Geotextile
Non-woven 6oz/yd² fabric over marginal clay before stone placement
Stone Base
6"–8" #53 INDOT-spec stone · placed in 6" lifts
Compaction
Standard Proctor density (ASTM D698) · plate compactor or vibratory roller
Grade Check
Laser level · ±¼" tolerance over slab footprint
Slope-Away
Minimum 1% (⅛" per foot) from any structure
Drainage Tie-In
Daylight, swale, or piped to structure per site conditions
04 · Process

Survey to pour-ready in four phases.

01

Survey & Locate

Site walk, soil probe, 811 utility locates, and elevation benchmarks set against finish floor or driveway tie-in.

02

Strip & Excavate

Topsoil and organics stripped to firm bearing. Footers, foundations, and pads cut to depth. Cut-and-fill balanced where possible to minimize haul.

03

Bridge & Fabric

Soft spots over-excavated and bridged with #53 stone. Geotextile placed on marginal subgrades to prevent pumping.

04

Stone & Compact

6"–8" of #53 stone placed in 6" lifts and compacted to Standard Proctor density Proctor. Final laser grade check, then ready for forms.

05 · Local Notes

Soils and permits across Madison, Hamilton & Boone County.

Anderson: Heavy clay across most of the city. Soft pockets near the White River bottoms require deeper strip and engineered fill. ROW Excavation Permits handled where work touches the public right-of-way.

Pendleton: Mixed clay and silty topsoil on rural drives. I-69 corridor work has changed local drainage flow — we re-survey ditch and culvert sizing on every job in this area.

Fishers, Carmel, Westfield, Noblesville: Glacial till generally gives better natural bearing, but new-construction sites are usually cut-and-fill of unknown quality. We probe and document before quoting. Fishers Activity Permit and Carmel ROW permits handled in-house.

06 · FAQ

Common questions about excavation and grading.

How deep do you excavate for a concrete slab?
It depends on the slab type and local frost depth. Indiana's frost depth is 30–36 inches, but a typical residential slab doesn't require frost-depth footings — it requires that all organics and soft material be removed and replaced with compacted stone. For a standard 4-inch residential slab, we strip 6–12 inches of topsoil and organics and replace with 6–8 inches of compacted #53 stone base. Footings and foundations go to frost depth.
What does "Standard Proctor density" mean and why does it matter?
Proctor is the lab test that determines how dense a specific soil or stone can get under compaction. Standard Proctor density means the base material is compacted to Standard Proctor density of its maximum possible density. Below that threshold, the base will continue settling under load — which causes the slab above it to crack and sink. All our stone base is compacted to Standard Proctor density Proctor minimum, verified with a nuclear density gauge on larger commercial pours.
What kind of soil should I expect in Anderson and Madison County?
Heavy clay throughout most of the city and the White River bottomlands. Clay holds water, swells when wet, and shrinks when dry — which means a slab poured directly on undisturbed clay will move seasonally. We always strip to firm bearing and replace with compacted granular base. Near the river, soft organic pockets are common and require deeper excavation or engineered fill.
How do you handle underground utilities before excavating?
We call 811 (Indiana's Dig Safe service) before every job. Utilities are marked within 2–3 business days. We hand-dig within 18 inches of any marked utility. On commercial sites with conduit, fiber, or gas mains not mapped by 811, we use a vacuum excavator to expose and confirm depth before power equipment moves in.
Do I need permits for excavation work in Fishers or Carmel?
For work that touches the public right-of-way — driveway aprons, curb cuts, drainage swales near the street — yes. Fishers requires an Activity Permit; Carmel requires a ROW permit through their online portal. We handle the application and coordinate inspections as part of the project. On-property-only excavation for a residential slab pad typically does not require a separate permit beyond the building permit, if applicable.
07 · External

Indiana earthwork standard.

Excavation depth, subgrade compaction requirements, and stone base specifications for Indiana projects follow the Indiana Department of Transportation Standard Specifications for Road and Bridge Construction (INDOT). Section 203 (Roadway Excavation) and Section 204 (Embankment) define compaction testing and fill placement requirements that we apply to all commercial and civil-adjacent work.

REF · INDOT Indiana Department of Transportation — Standard Specifications for Road and Bridge Construction
